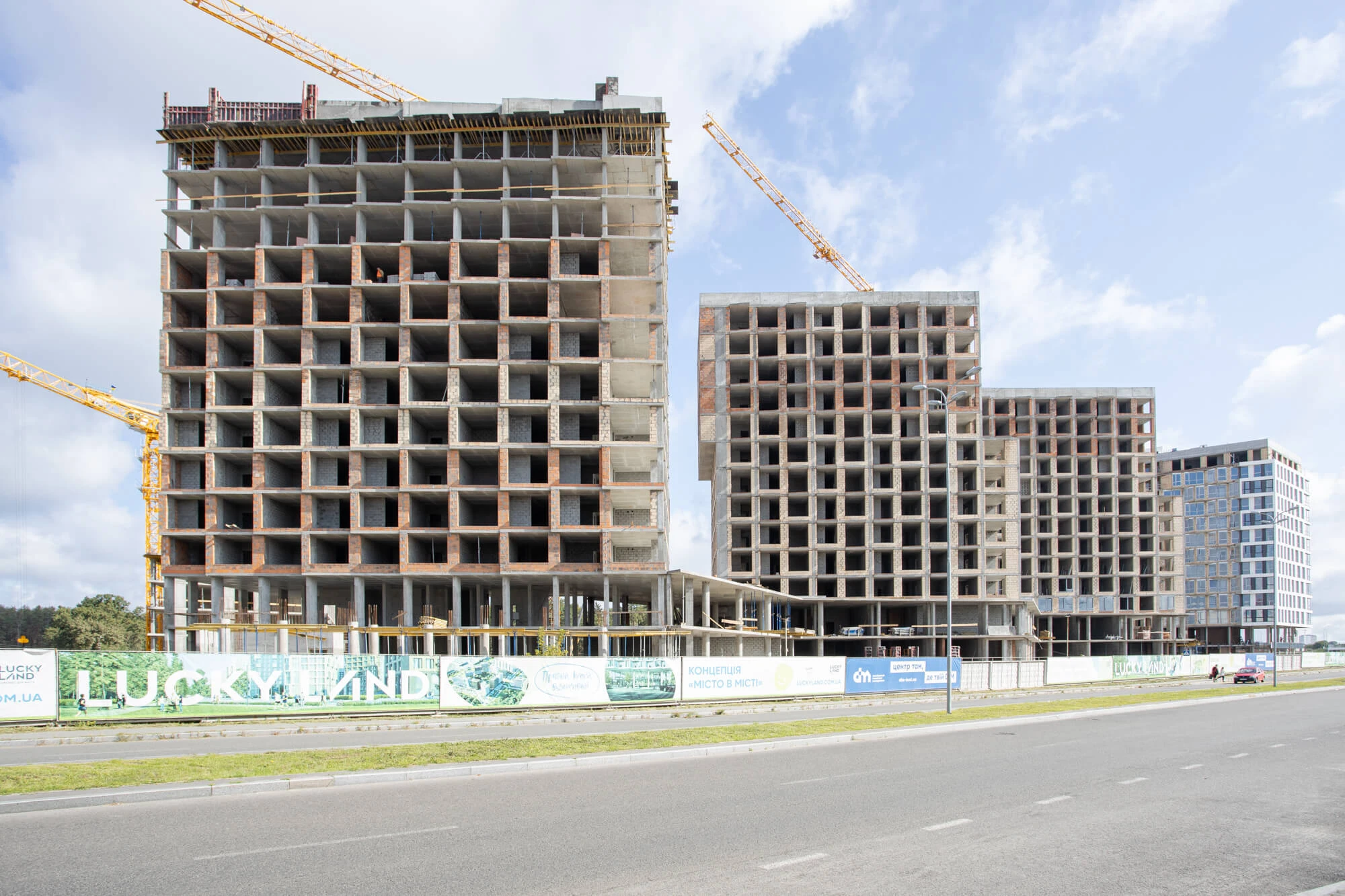

In August 2021, the following works are being carried out at the construction site of the "LUCKY LAND" housing complex:

Building No. 3, Section 1:

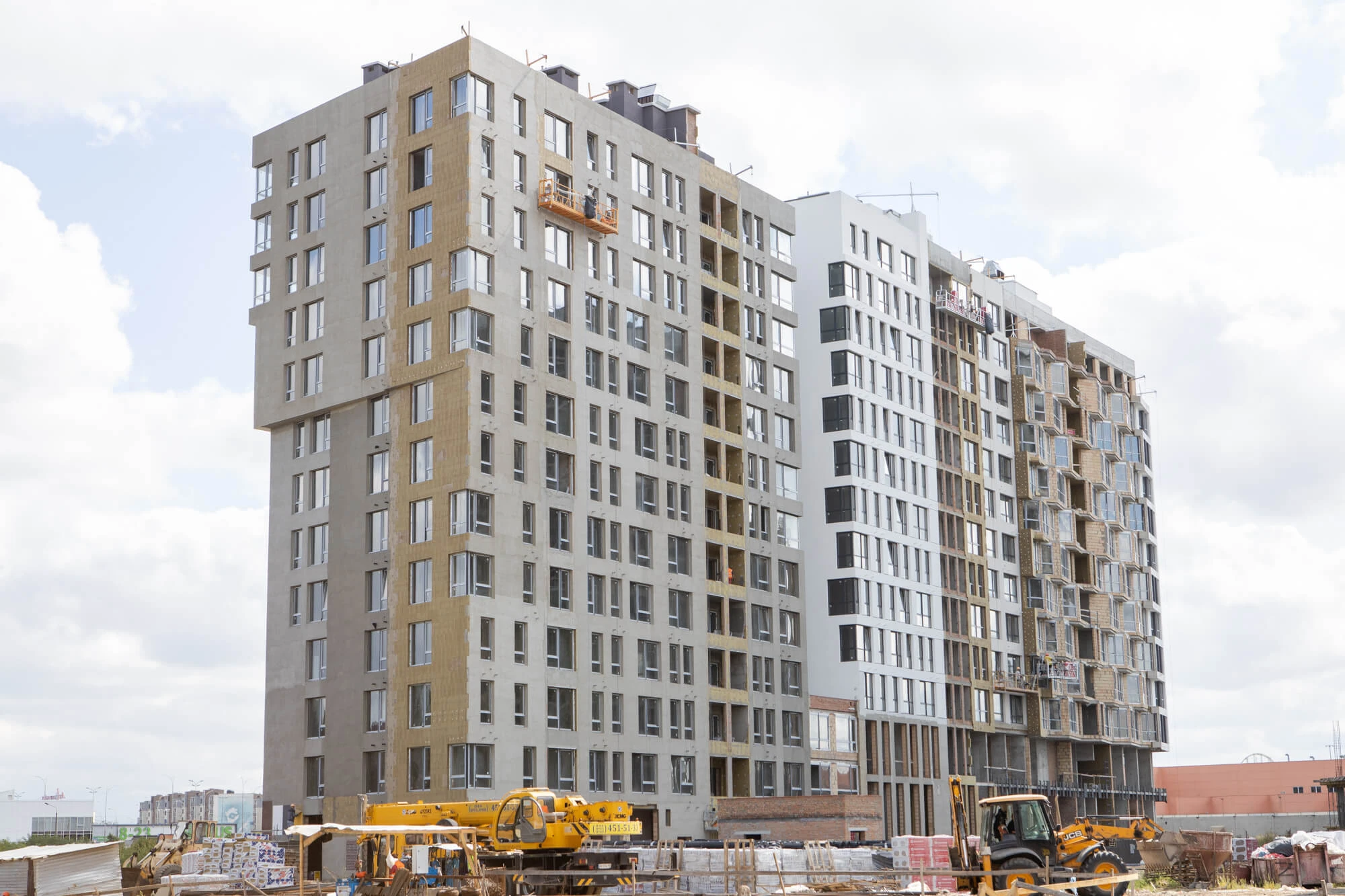

Works on insulation and decoration of the facade are being carried out.

The work on the installation of elevator equipment has been completed.

The installation of apartment switchboards has been completed.

Work on glazing the first floors is underway.

Work is underway to install metal fences on stairwells and cold passages.

Installation of splinker fire extinguishing systems in basements is underway.

Building No. 3, Section 2:

Works on insulation and decoration of the facade are being carried out.

The work on the installation of elevator equipment has been completed.

Work is underway to install metal fences on stairwells and cold passages.

Installation of splinker fire extinguishing systems in basements is underway.

Building No. 3, Section 3:

Work on the installation of screeds in apartments and MOP on the 2nd, 12th and 13th floors has been completed.

Works on insulation and decoration of the facade are being carried out.

Installation of elevator equipment has been completed.

Work is underway to install metal fences on stairwells and cold passages.

Installation of splinker fire extinguishing systems in basements is underway.

Building No. 3, Parking:

Works on the arrangement of the splinker fire extinguishing system are being carried out.

Work is being carried out on the installation of fire alarm cabling.

Works on installation of smoke removal and ventilation systems are being carried out.

Works on the installation of storm sewers are being carried out.

Works on the arrangement of fire-fighting water supply are being carried out.

Works on laying and installation of electricity supply are being carried out.

Building No. 3, Stilobate part:

Work is being carried out on the arrangement of the vertical elements of the stylobate part of the 2nd floor.

Building No. 4, Section 1:

Completed works on waterproofing the roof.

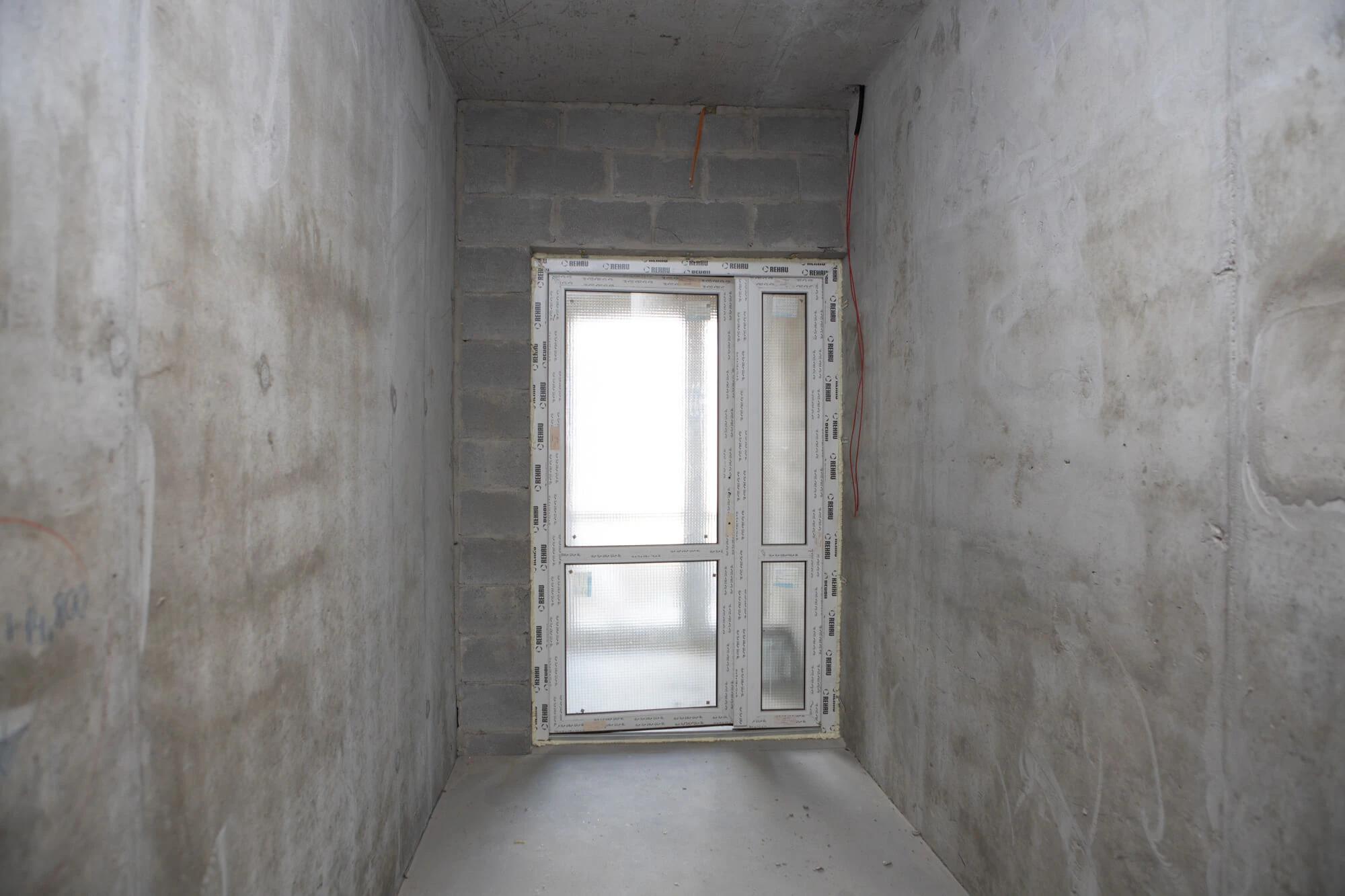

Installation of PVC structures on the 3rd, 4th, 5th and 6th floors is being carried out.

Work on the arrangement of the monolithic frame of the stylobate part has been completed.

Building No. 4, Section 2:

The work on the arrangement of the monolithic frame of section 4.2 has been completed.

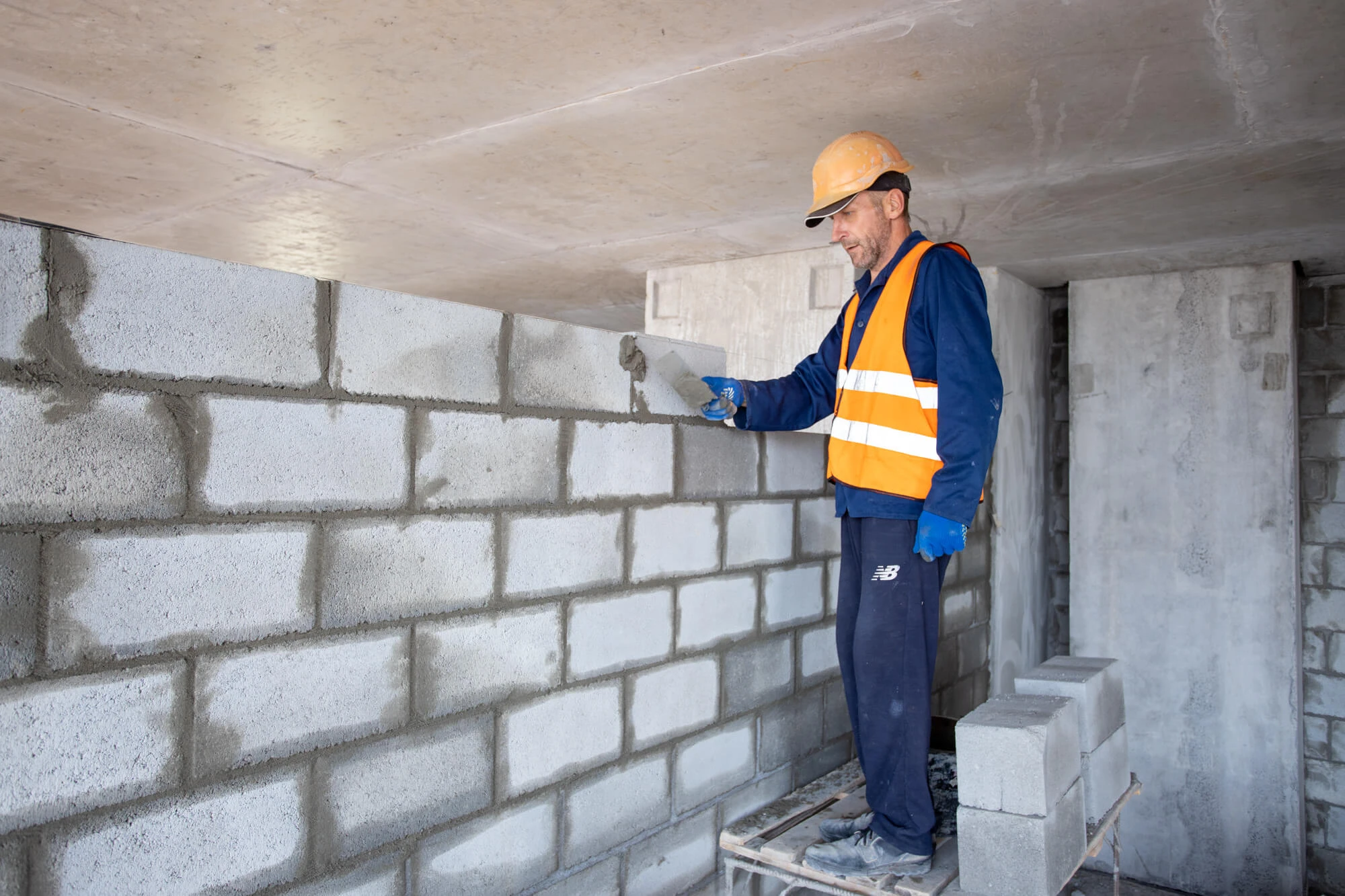

Work on the arrangement of brickwork on the residential floors has been completed.

Brickwork is being done on the roof.

Work on the arrangement of the monolithic frame of the stylobate part has been completed.

Building No. 4, Section 3:

Work is being carried out on the arrangement of the slab covering the technical superstructures on the roof.

Work is being carried out on the arrangement of the vertical elements of the stylobate part of the 1st floor.

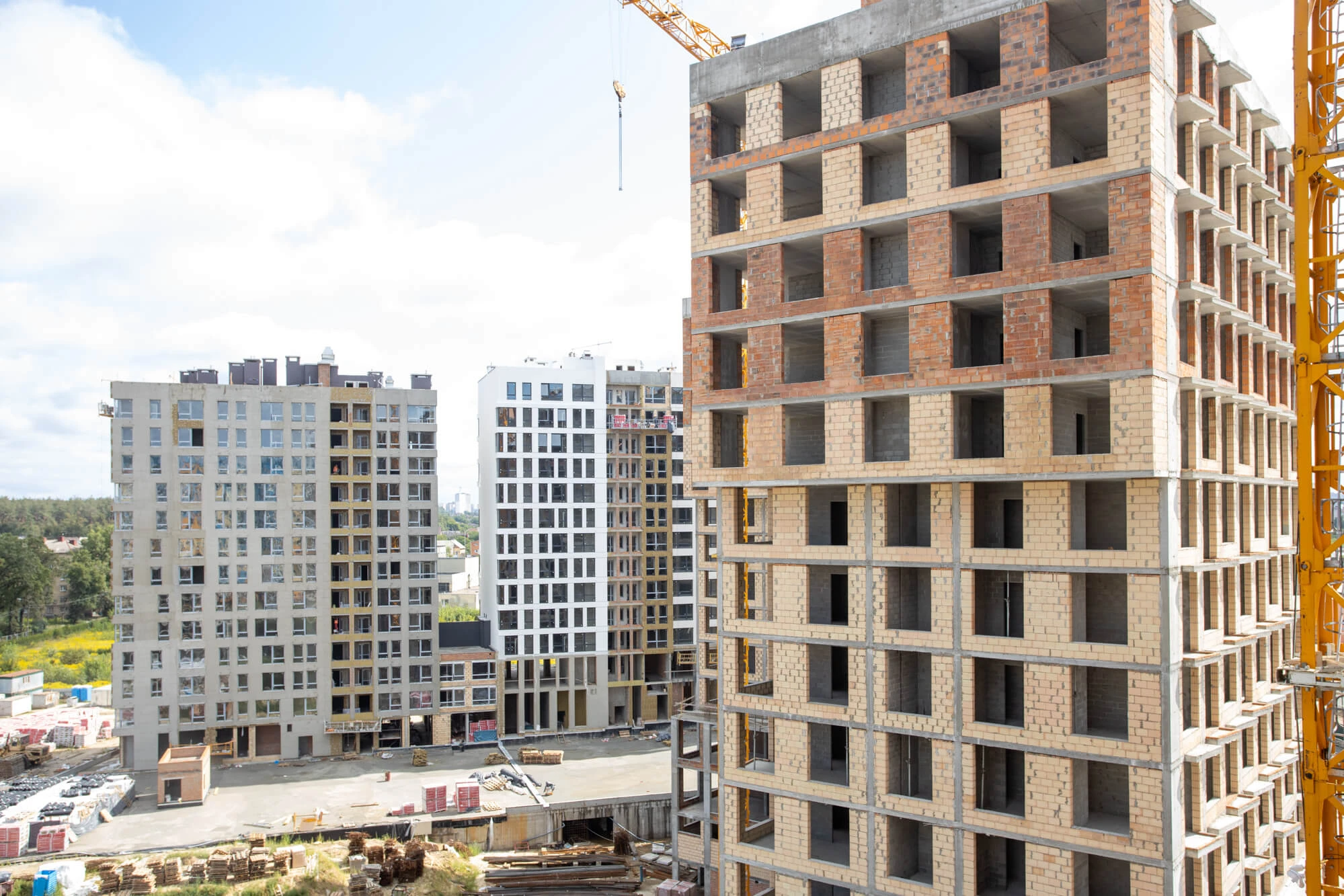

Work is underway to arrange brickwork from the 8th to the 11th floor.

Building No. 6, Section 1:

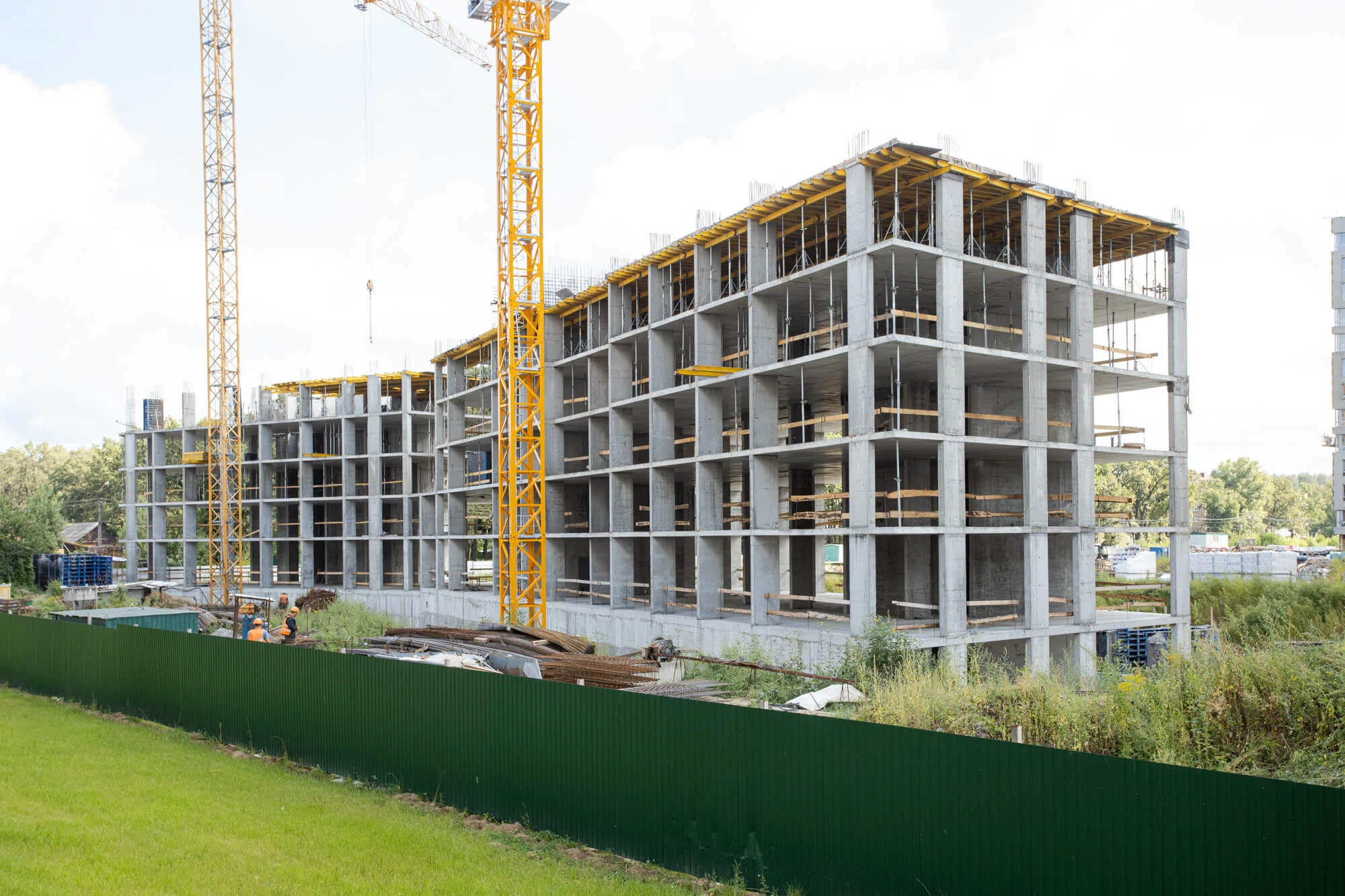

Work is being carried out on the arrangement of the floor slab of the 5th floor.

Building No. 6, Section 2:

Work is being carried out on the arrangement of the vertical elements of the 6th floor.

Building No. 5, Section 1, 2, 3:

The foundation slab of sections 5.1 and 5.2 has been concreted.

Work is being carried out on the arrangement of the foundation slab of section 5.3.

Work on the construction of the foundation of the tower crane is underway.
