A136 Highlight Tower
Construction progress for January 2026

30.01.2026

Go back

Construction progress of A136 Highlight Tower for January 2026:

  • Finishing works continue, walls decoration with decorative plaster (marble) on the 5th and 33rd floors.
  • Installation of suspended ceilings (cube-rail) from the 6th to the 33rd floor - 95%.
  • Installation of ceramic tiles on stair landings - 57%, and on the garage - 90%.
  • Lobby decoration (wall plastering, wall and floor decoration with ceramic tiles) - 100%, wall decoration with veneer in progress.
  • Parking floor installation - 95%.
  • Equipment installation in the transformer substation continues.
  • Installation of passenger elevators (commissioning works) - 97%.
  • Installation of ventilation shaft grilles on the roof - 92%.
  • Installation of gravel and sand preparation for landscaping - 93%.
  • Continuation of the installation of monolithic structures for stairs and central entrance wings.

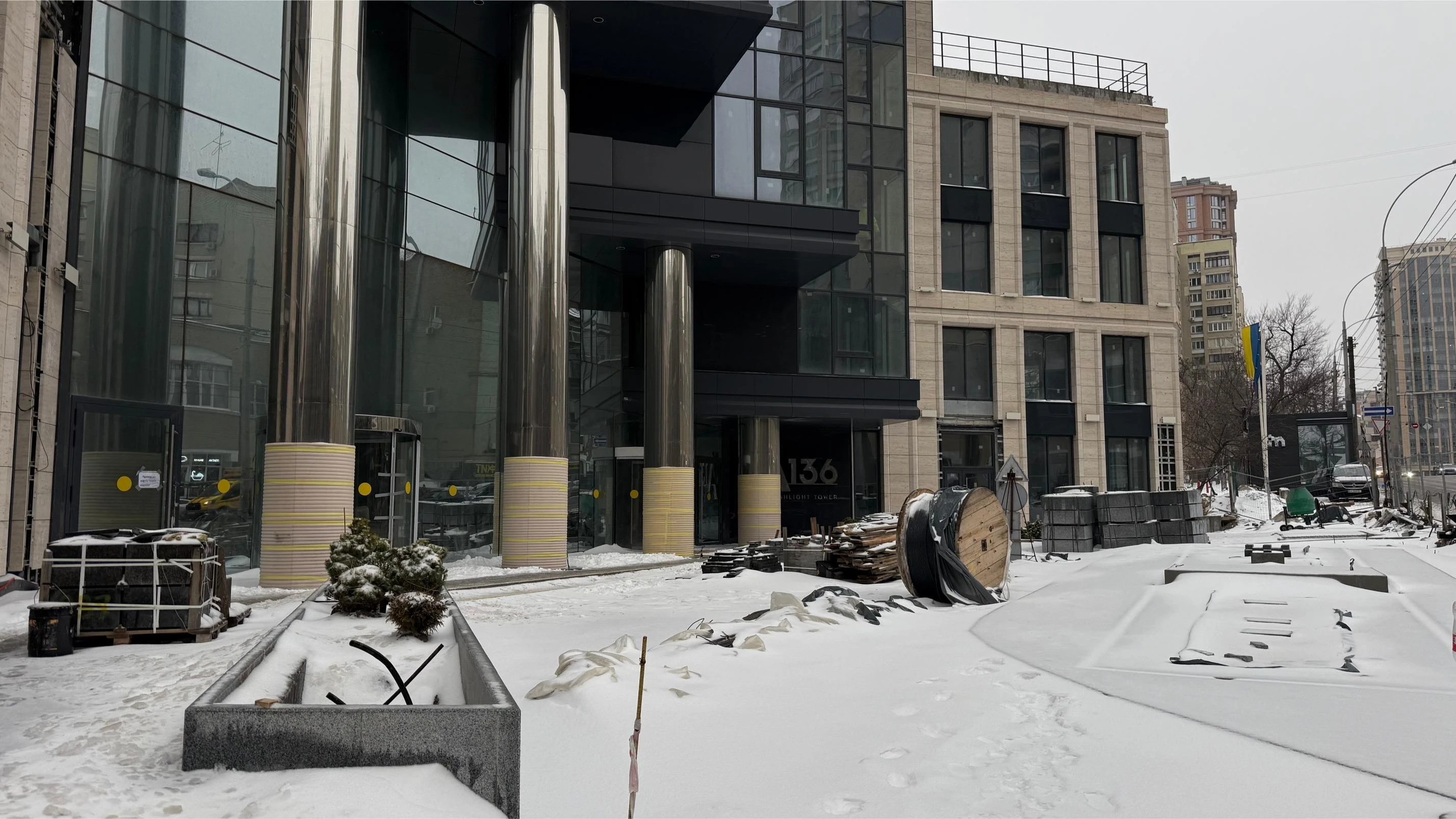

  • Installation of granite paving for the central entrance - 92%.
  • Continuation of installation of wheel stops and marking in the parking lot.
  • Landscaping works are in progress.
